Nothing hurts a fashion brand more than missing a selling season. You have the designs, the marketing is ready, but your shipment is stuck—not because of a port strike, but because of a failed OEKO-TEX test. This is a common, yet preventable, nightmare. Seasonal delays in certified production aren’t about bad luck; they’re almost always about poor planning and reactive processes.
The only reliable way to avoid seasonal delays with OEKO-TEX certified production is to integrate compliance into the very front end of your development calendar, using a manufacturer with the systems to pre-test and pre-qualify materials, and to plan for certification as a non-negotiable phase of your timeline, not an afterthought. It’s about proactive strategy, not crisis management.
At its core, this is a project management challenge. Treating certification as a final inspection is a recipe for disaster. Instead, it must be a parallel track running alongside design, sampling, and production planning. Let me share the exact framework we use with our partners at Shanghai Fumao to ensure their seasonal collections land on time, every time.
Why Does Certification Typically Cause Delays?
Delays happen when certification is treated as a surprise final exam rather than an open-book test you’ve been preparing for all semester. The conventional, linear process is the bottleneck.
The traditional model—finish development, then submit for certification—creates a single point of failure with a 3–4 week mandatory wait. If the product fails, you must re-source materials, remake samples, and resubmit, adding 6–8 weeks easily. This directly collides with production and shipping deadlines. A client came to us two years ago after a previous supplier’s failure on a line of children’s swimwear for pH and formaldehyde delayed their key summer launch by 10 weeks. They sold the inventory at a 70% loss in the fall.
What Are the Most Common Failure Points That Cause Setbacks?
Understanding where things go wrong is half the battle. Based on hundreds of tests, these are the usual suspects:
- Fabric pH Imbalance: Especially common in natural fibers like cotton or in fabrics with special finishes. It's a quick test but a frequent fail.
- Unauthorized Colorants/AZO Dyes: Certain dyes, particularly in dark or vibrant colors like blacks and reds, can break down into restricted aromatic amines.
- Heavy Metals in Trims & Prints: Zippers, buttons, and screen prints can contain lead, cadmium, or nickel exceeding limits.
- Formaldehyde in Wrinkle-Resistant Finishes: A functional finish that often pushes chemical levels over the edge.
Each of these requires a different fix—from simple re-washing to finding new component suppliers—and each fix takes time you don’t have during crunch time.
How Does the "Just-In-Time" Mentality Backfire?
Many brands, pressured by fast fashion cycles, try to compress timelines by sourcing materials and starting production before certification is secured. This is the highest-risk approach. You are essentially gambling that your $50,000 production run will pass a $1,500 test. In apparel manufacturing, this is an unacceptable financial risk. The cost of air freighting a delayed sea shipment to catch a season can often exceed the entire profit margin of the order.
What is the "Certification-First" Development Timeline?
The solution is to flip the script. Instead of making the product and then checking if it’s compliant, you define compliance as the first gate through which all materials must pass.

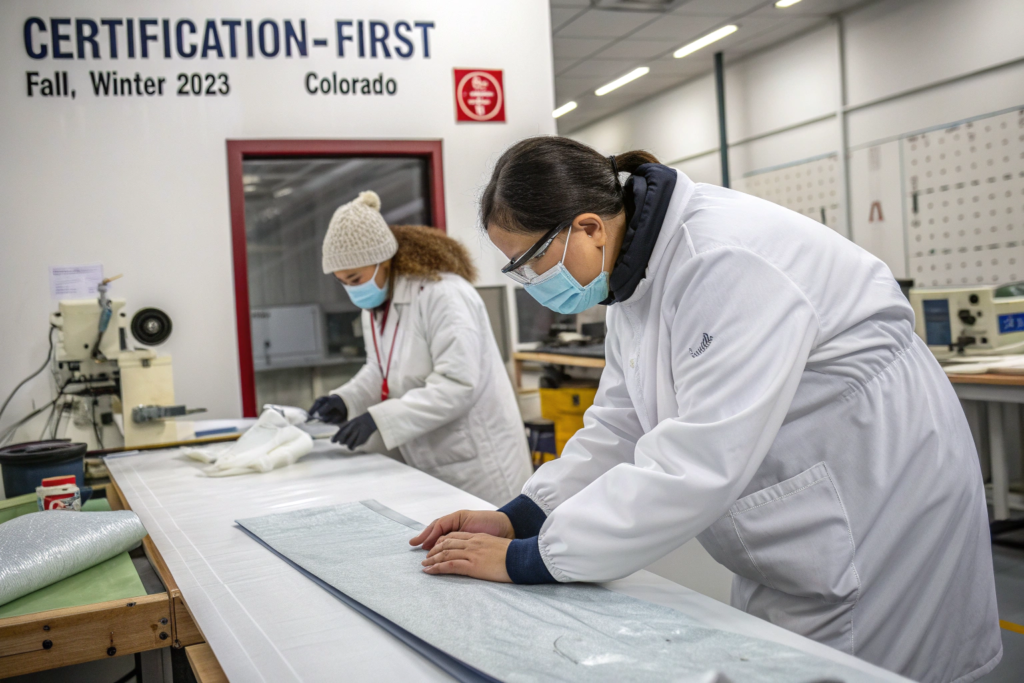

A "Certification-First" timeline adds 4-6 weeks to the very beginning of your development cycle for material pre-qualification, but it saves 8-12 weeks of potential delay at the end. It moves the risk window to a phase where changes are cheap and easy. For our Fall/Winter 2023 collection with a Colorado-based outerwear brand, we started lab pre-screening of insulation and membrane fabrics in January—right after the holiday break—for a July shipment. This gave us ample time to switch two fabric sources that showed irregular initial results.
How Do You Build This Into a Seasonal Calendar?
Here is a simplified, backwards-planned timeline for a Spring/Summer collection:
| Milestone | Traditional Risky Timeline | "Certification-First" Secure Timeline |
|---|---|---|
| Final Design & Material Selection | Month 1-2 | Month 1 |
| Material Pre-Testing & Sourcing | Not done, or done concurrently with sampling. | Month 2-3 (Critical Phase: Only OEKO-TEX certified fabrics and pre-screened trims are ordered in bulk.) |
| Prototyping & Fitting | Month 3 | Month 3 |
| Production Sample & OFFICIAL OEKO-TEX Submission | Month 4 (The Bottleneck: 4-week wait begins.) | Month 4 (Submission is a formality; sample is made from pre-approved materials.) |
| Bulk Production | Month 5-6 (Cannot start until cert passes.) | Month 4-5 (Production can start in parallel with official lab work.) |
| Shipment (Sea Freight) | Month 7 | Month 6 |
| Result | High risk of missing in-store date. | Guaranteed on-time delivery for season start. |
What is the Role of the Manufacturer in This Timeline?
Your manufacturer must act as the quarterback. They need to:
- Maintain a library of pre-certified fabrics and component suppliers.
- Have an in-house lab for rapid pre-testing (as we discussed in a previous article).
- Provide you with a transparent, shared project management calendar that includes all testing milestones.
This level of organization is what separates a true partner from a basic contractor.
How Can Pre-Testing and In-House Labs Save Critical Weeks?
This is the most powerful tactical advantage. Access to immediate testing data transforms guesswork into guided decision-making.
An in-house or partnered lab for pre-testing compresses the feedback loop from weeks to days or even hours. When a material sample arrives at our facility, we can run basic pH, formaldehyde, and colorfastness tests within 24-48 hours. This allows our product development team to approve or reject materials before they ever enter the sampling queue. For a recent activewear line, this process identified a problematic antibacterial finish on a polyester fabric. We had the mill adjust their process and sent a new sample for re-testing within one week, a cycle that would have taken over a month using an external lab.
What Specific Tests Should Be Done In-House Before Official Submission?
Focus on the high-probability, quick-turnaround tests:
- pH and Moisture Content: For all skin-contact fabrics.
- Formaldehyde (extracted from solution): For any woven fabrics, especially shirts and trousers.
- Heavy Metals Scan (XRF): For all metal trims, zippers, buttons, and printed fabrics.
- Colorfastness to Perspiration & Rubbing: For all dyed materials.
Passing these pre-tests doesn’t guarantee a full OEKO-TEX pass, but it eliminates over 80% of common failure reasons, de-risking the official submission enormously.
How Does This Integrate with DDP (Delivered Duty Paid) Shipping?
For DDP shipments, where the supplier manages all logistics and assumes risk until delivery, certification certainty is even more critical. A delay caused by a failed test becomes the supplier’s direct financial problem. Therefore, reputable DDP providers, like us at Shanghai Fumao, are inherently incentivized to build robust pre-testing into our process. It protects our schedule and our client’s go-to-market plan. This alignment of interests is a key reason to choose a full-package, DDP-capable manufacturer for certified goods.
What Contingency Plans Should You Have in Place?
Even with the best planning, surprises can happen. A proactive brand and factory partnership plans for contingencies at the material level.
The core contingency plan is to have pre-approved backup material options for your key fabrics and components. This is decided during the initial material selection phase. We call it the "A/B Material Strategy." For example, when developing a line of certified organic cotton sweaters, we always source and pre-test yarn from two different certified mills. If an unexpected issue arises with the primary mill’s batch, we can immediately switch to the approved backup without restarting the certification clock.
How Do You Build a "Safety Buffer" into the Shipping Plan?
Always assume the official certification will take the full standard time (4 weeks). Then, add a 1-2 week buffer after receiving the certificate before your cargo must be at the port. This buffer accounts for any last-minute administrative hiccups or final corrections on the test report. Crucially, this buffer time should be used for finalizing logistics, not for waiting on test results. Smart brands also discuss air freight options with their manufacturer in advance, understanding the cost, so a last-minute decision can be made quickly if absolutely necessary—though the goal is to never need it.
Why is Transparent Communication the Ultimate Contingency?
Weekly update calls between the brand’s production manager and the factory’s project lead are non-negotiable. These calls should review the testing schedule, factory audit reports, and any potential red flags openly. Early warning is everything. A good partner will tell you a potential problem the moment they see it, not hide it hoping it will go away. This trust-based, transparent communication is the glue that holds the complex process together and is a cornerstone of how we operate with our partners.
Conclusion
Avoiding seasonal delays with OEKO-TEX production is not about finding a shortcut; it’s about building a smarter, more resilient pathway. It requires a fundamental shift from reactive to proactive planning, leveraging pre-testing technology, and fostering a truly collaborative partnership with your manufacturer. By adopting a "Certification-First" timeline, investing in pre-qualification, and building in smart contingencies, you transform certification from your biggest scheduling threat into a predictable, managed step in your workflow.
The goal is to make on-time delivery of certified goods a boring, reliable outcome—not a thrilling cliffhanger. Your brand’s success depends on it. If you’re ready to implement a system that protects your seasonal launches, let’s build a plan together. Contact our Business Director Elaine at elaine@fumaoclothing.com to schedule a planning session for your next collection.
