When planning your seasonal inventory, a vague or optimistic production timeline can derange your entire business. For Realtree-patterned workwear, the timeline isn’t just about sewing—it’s a multi-stage journey involving licensing, specialized materials, and rigorous approvals. You need a realistic schedule, not a best-case estimate, to ensure your rugged apparel arrives when your customers need it most.
The total production timeline for bulk Realtree-patterned workwear typically ranges from 90 to 120 days from order confirmation to goods being ready to ship. This period includes mandatory design approval from Realtree (2-4 weeks), specialized fabric sourcing (2-3 weeks), bulk production and quality control (5-6 weeks), and final logistics preparation (1 week).
Understanding each phase’s duration and dependencies is crucial for setting accurate expectations with your sales team and retail partners. This timeline reflects a streamlined process with an experienced, licensed manufacturer; working with an unqualified factory can extend this significantly.
Why does the licensor approval phase take 2-4 weeks?
This is the single most non-negotiable and time-consuming phase that differentiates licensed apparel from regular workwear. No factory can legally cut a single inch of Realtree fabric without formal approval from the licensor for your specific design. This gate exists to protect the integrity of the Realtree brand.
The 2-4 week approval period is required for Realtree’s compliance team to review your technical package, ensuring your logo application, garment design, and final product presentation align with their strict brand guidelines. This process cannot be rushed and depends on the licensor’s internal schedule and the completeness of your submission.

What exactly is being reviewed during approval?
Realtree’s team scrutinizes several key elements:
- Logo Placement and Size: They verify that your brand’s logo does not overshadow or degrade the recognizability of the camo pattern. Placement on the chest, back, or sleeve must meet their guidelines.
- Application Method: The technique (embroidery, patch, printing) and the specific thread or ink colors are reviewed. For example, a logo must have sufficient contrast to be visible but not use colors that are not part of the official Realtree palette.
- Garment Style and Context: They ensure the workwear style (e.g., a high-visibility vest over a Realtree base) is appropriate and that the final product maintains a professional, rugged aesthetic consistent with their brand.
We manage this by preparing “camera-ready” submission packages for our clients, which include precise tech packs and digital mock-ups. An incomplete submission is the most common cause of rejection and timeline extension.
Can this phase be expedited?
Experience matters. While you cannot expedite Realtree’s internal process, you can prevent delays. Factories like Fumao Clothing with a long-standing licensing relationship and a history of compliant submissions often have a smoother, more predictable review process. We also advise clients to use pre-approved garment templates where possible, which can shorten review times. For a new client last quarter, we leveraged a pre-approved work shirt template, cutting their unique approval time down to 10 business days.
What are the sourcing and pre-production steps?
Once design is approved, the clock starts on physical production. However, the specialized nature of Realtree fabric and workwear-specific components means sourcing is not a simple warehouse pick-and-pack operation. It involves securing allocated material and custom trims.
This 3-4 week phase involves ordering and delivering the licensed fabric from an authorized mill, sourcing and confirming all trims (like heavy-duty zippers, reinforced rivets, and moisture-wicking linings), and producing final pre-production samples for your final sign-off before bulk cutting begins.

Why is fabric sourcing for Realtree unique?
Authentic Realtree fabric is produced under license by specific mills. These mills often have production cycles and minimum order quantities (MOQs). Your factory must place an order against the mill’s schedule. The fabric is then custom-printed, cured, and shipped to the factory. This procurement lead time is fixed and must be factored in. We mitigate this by forecasting and holding limited stock of popular base fabrics for our key clients, but for custom workwear blends or new patterns, the full lead time applies.

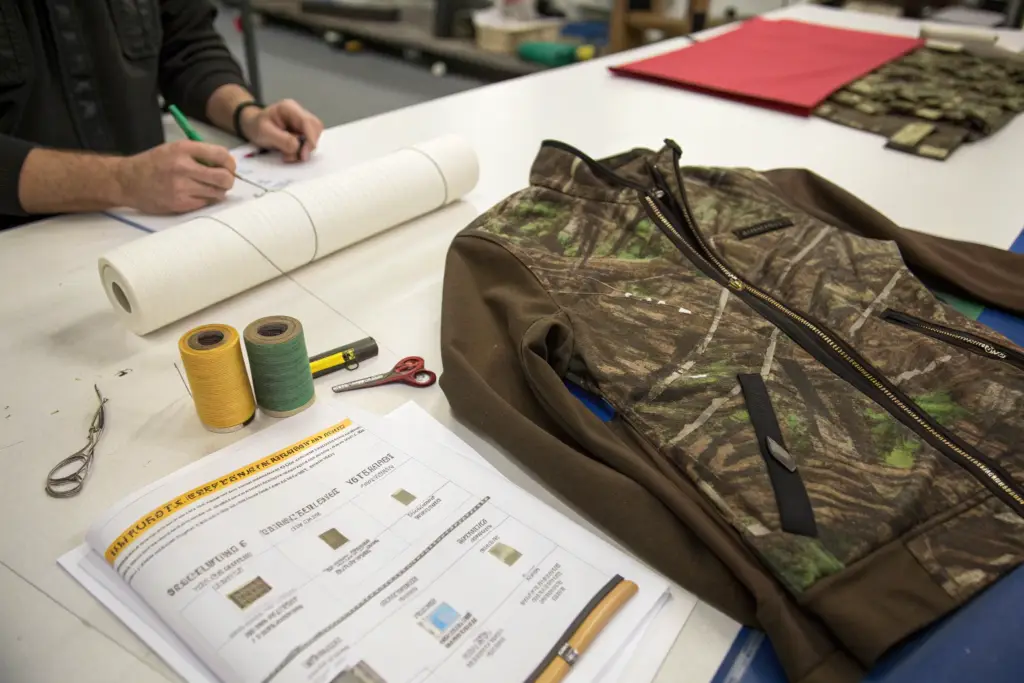

What is included in the final pre-production sample?
This is your last checkpoint. The Pre-Production (PP) Sample is made with the actual approved Realtree fabric and all correct trims. You must inspect and approve this sample for:
- Fit and Construction: Workwear requires durable stitching, bar tacks at stress points, and reinforced seams.
- Color and Pattern Match: Ensuring the printed fabric meets the approved strike-off and that pattern pieces align correctly at seams.
- Functionality: Testing pockets, zippers, ventilation, and other work-specific features.
Your formal approval of this sample triggers the bulk cutting order. Rushing or skipping this step leads to mass production of defective goods.
| Phase | Key Activities | Typical Duration | Dependency & Risk |
|---|---|---|---|
| 1. Design & Licensor Approval | Finalize tech pack, submit to Realtree, await approval. | 2 – 4 weeks | Critical Path. Delays here cascade. Dependent on licensor. |
| 2. Material Sourcing & PP Sample | Order fabric from mill, source trims, make PP sample, client approves. | 3 – 4 weeks | Dependent on mill schedule and client feedback speed. |
| 3. Bulk Production | Fabric spreading/cutting, sewing assembly, logo application, inline QC. | 5 – 6 weeks | Dependent on factory capacity and order quantity. Most stable phase. |
| 4. Final QC & Shipping Prep | Final random inspection, auditing, packing, export documentation. | 1 week | Dependent on QC results; rework can cause delays. |
How long does bulk production and quality control take?
This is the most physically intensive phase. For bulk orders of durable workwear, it’s not just about speed; it’s about maintaining consistent quality across hundreds or thousands of units while managing the complexities of a patterned fabric.
Bulk production for Realtree workwear typically requires 5-6 weeks. This includes pattern matching during cutting, multiple assembly lines for sewing, time-intensive logo application (like embroidery), and embedded in-line quality control checks. Rushing this phase compromises the durability and appearance your workwear customers demand.

Why does cutting and sewing take longer with camo fabric?
Unlike solid-color fabric, Realtree patterns must be matched at seams (e.g., where the sleeve attaches to the body) to maintain a continuous, professional look. This requires skilled cutters and special spreading techniques, which slow down the cutting process and can increase fabric waste. Sewing also requires more attention to align patterned panels correctly. These steps are non-negotiable for premium workwear.
What quality controls are embedded in the timeline?
QC is not a single event at the end; it’s a series of checkpoints that add time but prevent costly errors:
- During Cutting: Checking pattern alignment.
- During Sewing (Inline QC): Checking stitch quality, seam strength, and piece alignment.
- After Logo Application: Verifying embroidery density, placement, and cleanliness.
- Final Random Inspection (AQL): A statistically sampled audit of finished garments to an agreed Acceptable Quality Level (usually AQL 2.5 for workwear).
For a recent order of 5,000 Realtree insulated coveralls, our inline QC caught a minor inconsistency in the quilting stitch density early. Fixing it on the line added half a day but prevented a potential rejection of hundreds of finished units later.
How should shipping and logistics be factored in?
Your timeline isn’t complete when the last jacket is packed. You must account for the time to move goods from the factory floor to your destination. This period is highly variable based on your chosen Incoterms and shipping method.
You must add 1 week for final packing and export documentation at the factory, plus the transit time: 30-40 days for standard ocean freight to the US West Coast, or 5-7 days for express air freight. For the most predictable timeline, opt for the factory’s Full-Package, DDP (Delivered Duty Paid) service, which includes all logistics management.

What happens during the final week at the factory?
This week is for:
- Final Audit and Packing: Conducting the AQL audit, repairing any minor defects, and packing to your specifications (polybag, hanger, carton).
- Documentation: Preparing the commercial invoice, packing list, certificate of origin, and for licensed goods, any required license compliance certificates.
- Booking Logistics: Finalizing the booking with the shipping line or airline.
A factory with a streamlined export department, like ours, executes this in parallel to the final QC to save time.
How do shipping terms affect my planning?
- EXW or FOB: You or your agent are responsible for arranging international freight and customs clearance. Any delays in booking or documentation errors on your end are your risk. This adds unpredictable time.
- DDP: The factory manages everything. They have the incentive and expertise to book the most efficient route and handle clearance smoothly. This provides a single, more reliable ETA (Estimated Time of Arrival).
We strongly advise our workwear clients to use our DDP service for simplicity and reliability. It turns a complex variable into a fixed part of the quoted timeline.
Conclusion
A realistic production timeline for bulk Realtree workwear is a 90 to 120-day orchestration of legal compliance, specialized sourcing, careful manufacturing, and planned logistics. Each phase depends on the previous one, making upfront planning and clear communication with your manufacturer paramount. By understanding and respecting this timeline, you secure not just products, but your market position and customer trust.
Partnering with a manufacturer that transparently manages this entire chain is the key to on-time delivery. At Fumao Clothing, we guide our clients through each milestone, from licensor submission to DDP delivery, providing the realistic schedules and proactive updates needed for successful seasonal planning. To build a reliable timeline for your next Realtree workwear order, contact our Business Director, Elaine, at elaine@fumaoclothing.com. Let’s plan for your success.
